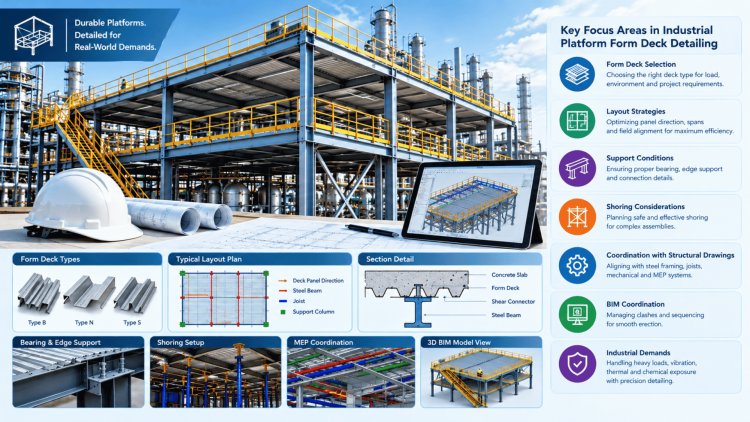

Form Deck Detailing for Industrial Platforms

Industrial platform projects demand a level of precision in form deck detailing that goes far beyond standard commercial floor applications. Unlike conventional construction scenarios, industrial platforms must accommodate heavy dynamic loads, vibration-intensive equipment, elevated thermal and chemical exposure conditions, and complex interface requirements with structural steel framing, joists, and mechanical systems — all within tight erection sequencing constraints. This presentation dives deep into the discipline-specific detailing practices that experienced steel deck detailers and BIM coordinators must master when working on industrial platform structures — from proper form deck selection and layout strategies to support conditions, bearing requirements, shoring considerations, and coordination with structural drawings. It is a practitioner-level guide built for those who have moved beyond the basics and are navigating the real-world complexity of industrial deck production d

Form Deck Detailing for Industrial Platforms
Industrial Platforms • Form Deck • Heavy-Duty Detailing

Understanding Form Deck in Industrial Context

Structural Role

What Is
Form Deck?

Typical Depths
9/16″ • 1½″

Form deck — typically a 9/16″ or 1½″ deep corrugated steel panel — functions as a permanent structural stay-in-place form for concrete slabs. Unlike composite deck, it does not engage structurally with the hardened concrete via embossments or shear studs; its primary role during construction is to support wet concrete dead load, construction live loads, and to provide a continuous lateral diaphragm prior to slab cure. On industrial platforms specifically, form deck is selected when slab thicknesses are driven by heavy equipment point loads, process vessel pads, or elevated live load requirements (often 250–500+ psf), making the deck primarily a forming surface rather than a load-sharing composite member.

Construction-Stage Function
Wet Concrete
Dead Load
+
Construction
Live Loads
+
Lateral Diaphragm
Prior to Cure
Elevated Live Loads
250–500+
psf
Industrial Platform Context
Heavy equipment point loads, process vessel pads, and elevated live load requirements can make the deck primarily a forming surface rather than a load-sharing composite member.
Industrial Detailing Conditions

Why Industrial Platforms
Are Different

05

Detailers working on power plants, petrochemical structures, offshore topsides, and heavy manufacturing platforms encounter conditions that fundamentally alter standard form deck detailing assumptions.

Form Deck Detailing

Critical Detailing Requirements:
Layout, Bearing & Support Conditions

Proper form deck detailing on industrial platforms is principally driven by three interdependent technical domains: deck panel layout and orientation, bearing conditions at supports, and the interface with primary and secondary structural framing. Errors in any one of these areas can generate costly RFIs, erection delays, or—in worst cases—structural deficiencies during concrete placement.

THREE
INTERDEPENDENT DOMAINS

Panel Layout & Orientation, Bearing Conditions at Supports, and Interface with Primary and Secondary Structural Framing Must Be Coordinated Precisely to Avoid Costly RFIs, Erection Delays, or Structural Deficiencies

On industrial platforms, flutes run perpendicular to the supporting beams or joists in standard configurations—this is the assumed direction for all published span table values. End laps must land on a structural support with minimum 1½" bearing per ANSI/SDI specification. Form deck must bear positively on each support member with minimum 1½" end bearing (SDI minimum), though industrial platforms with vibration or thermal cycling may require increased bearing or positive attachment at every flute valley. When slab thickness and wet concrete weight exceed the unshored span capacity of the selected form deck, intermediate shoring must be detailed with a dedicated shoring plan showing shore locations, allowable post loads, and stripping sequence tied to concrete cure schedule—this is not optional documentation but a contractual deliverable on most industrial projects.

01
LAYOUT DOMAIN

Panel Layout & Orientation Strategy

The orientation of form deck flutes relative to support framing must be clearly communicated on every deck plan. On industrial platforms, flutes run perpendicular to the supporting beams or joists in standard configurations—this is the assumed direction for all published span table values. Detailers must flag and engineer any condition where constraints force a parallel-to-support orientation, as slab spanning assumptions change fundamentally.

Flute orientation: Flutes run perpendicular to supporting beams or joists in standard configurations—this is the assumed direction for all published span table values; detailers must flag and engineer any parallel-to-support orientation as slab spanning assumptions change fundamentally.
End laps vs. side laps: End laps (where one sheet overlaps another end-to-end) must land on a structural support with minimum 1½" bearing per ANSI/SDI specification; side laps must be fastened per diaphragm design requirements called out on structural drawings.
Sheet starting point: Begin layout from a control line established by the structural engineer—not from a column face—to maintain consistent module across the platform.
Closure conditions: Edge conditions at platform perimeter, penetrations, and slab blockouts require closure strips, pour stops, and angle closures detailed at correct height relative to top of slab elevation.
Skewed framing: When supporting beams are skewed relative to deck run direction, triangular filler pieces or field-cut panels must be detailed with clear cut-line dimensions and fastening requirements.
Span table assumption: On industrial platforms, flutes run perpendicular to the supporting beams or joists in standard configurations—this is the assumed direction for all published span table values; detailers must flag and engineer any parallel-to-support orientation as slab spanning assumptions change fundamentally.
02
BEARING DOMAIN

Bearing Conditions at Structural Supports

Form deck must bear positively on each support member. Industrial platform structures commonly use wide-flange beams, HSS members, or open-web steel joists as supports—each presenting different bearing surface widths and detailing implications.

Minimum bearing: 1½" end bearing is the SDI minimum; however, on industrial platforms where vibration or thermal cycling is expected, detailers should coordinate with the structural engineer on whether increased bearing or positive attachment at every flute valley is required.
Beam flange width vs. deck module: When beam flange widths are narrow (e.g., W8 or W10 sections), the detailer must verify that minimum bearing is achievable without requiring both sheet ends to share a single narrow flange—a common coordination error in congested framing areas.
Attachment at supports: Puddle welds (typically 5/8" diameter arc spot welds) or powder-actuated fasteners are specified at each support; the pattern (e.g., 36/7—weld at every flute at ends, every other at interior) must match the diaphragm calculation or be explicitly noted as "by EOR."
Joist bearing interface: Where form deck bears on open-web steel joists, deck attachment must avoid bridging rows and account for joist chord geometry to ensure positive weld contact without arcing on chord angles.
Industrial platform consideration: On industrial platforms where vibration or thermal cycling is expected, detailers should coordinate with the structural engineer on whether increased bearing or positive attachment at every flute valley is required—1½" end bearing is the SDI minimum but may not be sufficient for dynamic loading conditions.
03
SHORING DOMAIN

Shoring Plan Coordination

When slab thickness and wet concrete weight exceed the unshored span capacity of the selected form deck, intermediate shoring must be detailed. The deck drawing set should include a dedicated shoring plan showing shore locations, allowable post loads, and stripping sequence tied to concrete cure schedule.

Unshored span capacity: When slab thickness and wet concrete weight exceed the unshored span capacity of the selected form deck, intermediate shoring must be detailed to prevent excessive deflection or structural failure during concrete placement.
Dedicated shoring plan: The deck drawing set should include a dedicated shoring plan showing shore locations, allowable post loads, and stripping sequence tied to concrete cure schedule—this is not optional documentation but a contractual deliverable on most industrial projects.
Stripping sequence: Shoring stripping sequence must be tied to concrete cure schedule to ensure concrete has achieved sufficient strength before shores are removed—premature stripping can cause slab cracking or collapse.
Contractual requirement: The deck drawing set should include a dedicated shoring plan showing shore locations, allowable post loads, and stripping sequence tied to concrete cure schedule—this is not optional documentation but a contractual deliverable on most industrial projects.
04
EDGE DOMAIN

Edge Angle & Pour Stop Selection

At slab edges, pour stops must match the top-of-slab elevation exactly. On industrial platforms with variable slab thickness zones (e.g., equipment pads vs. standard platform slab), multiple pour stop heights may appear within the same bay.

Top-of-slab elevation match: At slab edges, pour stops must match the top-of-slab elevation exactly—incorrect pour stop height results in concrete spillage or edge profile defects.
Variable slab thickness zones: On industrial platforms with variable slab thickness zones (e.g., equipment pads vs. standard platform slab), multiple pour stop heights may appear within the same bay—each transition must be detailed with a section cut showing the step condition, the pour stop profile, and the attachment to the perimeter framing.
Transition detailing: Each transition between different slab thickness zones must be detailed with a section cut showing the step condition, the pour stop profile, and the attachment to the perimeter framing—field crews cannot be expected to interpret variable conditions without explicit detail.
Section cut requirement: On industrial platforms with variable slab thickness zones, each transition between different pour stop heights must be detailed with a section cut showing the step condition, the pour stop profile, and the attachment to the perimeter framing—field crews cannot be expected to interpret variable conditions without explicit detail.
05
CLEARANCE DOMAIN

Headed Stud Clearance (Even Without Composite Action)

Even when form deck is non-composite, structural engineers on industrial platforms occasionally specify headed studs on beams below the slab for connection of grating, checker plate covers, or secondary steel. Detailers must confirm stud height-to-deck profile clearance and flag any conflicts with flute geometry—particularly at 1½" deck where stud height restrictions are most binding.

Non-composite stud specification: Even when form deck is non-composite, structural engineers on industrial platforms occasionally specify headed studs on beams below the slab for connection of grating, checker plate covers, or secondary steel—studs are not only for composite action.
Height-to-profile clearance: Detailers must confirm stud height-to-deck profile clearance and flag any conflicts with flute geometry—studs must not interfere with deck ribs or prevent proper deck bearing.
1½" deck constraint: Particularly at 1½" deck where stud height restrictions are most binding, detailers must verify that specified stud height does not conflict with deck flute geometry—low-profile deck profiles leave minimal clearance for studs.
Conflict flagging: Any conflicts between stud height and deck flute geometry must be flagged during the detailing phase—field modifications to studs or deck are costly and can compromise structural connections.
Critical coordination: Even when form deck is non-composite, structural engineers on industrial platforms occasionally specify headed studs on beams below the slab for connection of grating, checker plate covers, or secondary steel—detailers must confirm stud height-to-deck profile clearance and flag any conflicts with flute geometry, particularly at 1½" deck where stud height restrictions are most binding.

Critical Detailing Requirements Summary

Domain Key Requirement Standard/Specification Common Error
Panel Layout & Orientation Flutes perpendicular to supports (standard); end laps on structural supports with min 1½" bearing; layout from control line (not column face) ANSI/SDI specification; published span tables assume perpendicular orientation Parallel-to-support orientation without engineering; end laps between supports; layout from column face instead of control line
Bearing Conditions Min 1½" end bearing (SDI); puddle welds or PAFs at each support; pattern must match diaphragm calculation or be noted "by EOR" SDI minimum 1½" bearing; diaphragm design requirements on structural drawings Both sheet ends sharing single narrow flange; attachment pattern not matching diaphragm calculation; arcing on joist chord angles
Shoring Plan Dedicated shoring plan required when wet concrete weight exceeds unshored span capacity; show shore locations, allowable post loads, stripping sequence tied to cure schedule Contractual deliverable on most industrial projects; stripping sequence tied to concrete cure schedule No shoring plan provided; stripping sequence not tied to cure schedule; premature shore removal causing slab cracking
Edge Angle & Pour Stops Pour stops must match top-of-slab elevation exactly; variable slab thickness zones require section cuts showing step condition, pour stop profile, and attachment Top-of-slab elevation must be matched exactly; section cuts required for transitions Pour stop height not matching top-of-slab elevation; no section cuts for variable slab thickness transitions; field crews interpreting variable conditions without explicit detail
Headed Stud Clearance Confirm stud height-to-deck profile clearance; flag conflicts with flute geometry; particularly critical at 1½" deck Stud height must not interfere with deck ribs or prevent proper deck bearing Studs conflicting with deck flute geometry; field modifications to studs or deck; compromised structural connections
DETAILING CRITICAL

Errors in Any One of These Areas Can Generate Costly RFIs, Erection Delays, or Structural Deficiencies During Concrete Placement

FIVE DOMAINS
01
Layout Flutes perpendicular to supports; end laps on supports with min 1½" bearing; layout from control line
02
Bearing Min 1½" end bearing; puddle welds or PAFs at each support; pattern matches diaphragm calculation
03
Shoring Dedicated shoring plan when wet concrete exceeds unshored capacity; stripping sequence tied to cure schedule
04
Edge Pour stops match top-of-slab elevation exactly; section cuts for variable slab thickness transitions
05
Studs Confirm stud height-to-deck profile clearance; flag conflicts with flute geometry; critical at 1½" deck
Proper form deck detailing on industrial platforms is principally driven by three interdependent technical domains: deck panel layout and orientation, bearing conditions at supports, and the interface with primary and secondary structural framing—errors in any one of these areas can generate costly RFIs, erection delays, or structural deficiencies during concrete placement.
CONTRACTUAL REQUIREMENT

Dedicated Shoring Plan Is Not Optional Documentation—It Is a Contractual Deliverable on Most Industrial Projects

When slab thickness and wet concrete weight exceed the unshored span capacity of the selected form deck, intermediate shoring must be detailed. The deck drawing set should include a dedicated shoring plan showing shore locations, allowable post loads, and stripping sequence tied to concrete cure schedule.

Shoring plan requirement When slab thickness and wet concrete weight exceed the unshored span capacity of the selected form deck, intermediate shoring must be detailed to prevent excessive deflection or structural failure during concrete placement. The deck drawing set should include a dedicated shoring plan showing shore locations, allowable post loads, and stripping sequence tied to concrete cure schedule—this is not optional documentation but a contractual deliverable on most industrial projects. Stripping sequence must be tied to concrete cure schedule to ensure concrete has achieved sufficient strength before shores are removed—premature stripping can cause slab cracking or collapse. Omitting a shoring plan or providing one without stripping sequence tied to cure schedule can result in erection delays, costly RFIs, and potential structural deficiencies during concrete placement.

The Critical Detailing Principle

Proper form deck detailing on industrial platforms is principally driven by three interdependent technical domains: deck panel layout and orientation, bearing conditions at supports, and the interface with primary and secondary structural framing. Errors in any one of these areas can generate costly RFIs, erection delays, or structural deficiencies during concrete placement. Five critical detailing requirements govern industrial platform form deck: (1) Panel Layout & Orientation Strategy—the orientation of form deck flutes relative to support framing must be clearly communicated on every deck plan; on industrial platforms, flutes run perpendicular to the supporting beams or joists in standard configurations (this is the assumed direction for all published span table values); detailers must flag and engineer any condition where constraints force a parallel-to-support orientation as slab spanning assumptions change fundamentally; end laps must land on a structural support with minimum 1½" bearing per ANSI/SDI specification; side laps must be fastened per diaphragm design requirements called out on structural drawings; layout should begin from a control line established by the structural engineer (not from a column face) to maintain consistent module across the platform; edge conditions at platform perimeter, penetrations, and slab blockouts require closure strips, pour stops, and angle closures detailed at correct height relative to top of slab elevation; when supporting beams are skewed relative to deck run direction, triangular filler pieces or field-cut panels must be detailed with clear cut-line dimensions and fastening requirements. (2) Bearing Conditions at Structural Supports—form deck must bear positively on each support member; minimum 1½" end bearing is the SDI minimum, though on industrial platforms where vibration or thermal cycling is expected, detailers should coordinate with the structural engineer on whether increased bearing or positive attachment at every flute valley is required; when beam flange widths are narrow (e.g., W8 or W10 sections), the detailer must verify that minimum bearing is achievable without requiring both sheet ends to share a single narrow flange; puddle welds (typically 5/8" diameter arc spot welds) or powder-actuated fasteners are specified at each support; the pattern (e.g., 36/7) must match the diaphragm calculation or be explicitly noted as "by EOR"; where form deck bears on open-web steel joists, deck attachment must avoid bridging rows and account for joist chord geometry to ensure positive weld contact without arcing on chord angles. (3) Shoring Plan Coordination—when slab thickness and wet concrete weight exceed the unshored span capacity of the selected form deck, intermediate shoring must be detailed; the deck drawing set should include a dedicated shoring plan showing shore locations, allowable post loads, and stripping sequence tied to concrete cure schedule—this is not optional documentation but a contractual deliverable on most industrial projects. (4) Edge Angle & Pour Stop Selection—at slab edges, pour stops must match the top-of-slab elevation exactly; on industrial platforms with variable slab thickness zones (e.g., equipment pads vs. standard platform slab), multiple pour stop heights may appear within the same bay; each transition must be detailed with a section cut showing the step condition, the pour stop profile, and the attachment to the perimeter framing. (5) Headed Stud Clearance (Even Without Composite Action)—even when form deck is non-composite, structural engineers on industrial platforms occasionally specify headed studs on beams below the slab for connection of grating, checker plate covers, or secondary steel; detailers must confirm stud height-to-deck profile clearance and flag any conflicts with flute geometry, particularly at 1½" deck where stud height restrictions are most binding.

INDUSTRIAL DECK • BIM • OPENINGS

Openings, Penetrations & BIM Coordination in Industrial Deck Detailing

Industrial platforms are defined by the sheer number, size, and complexity of slab penetrations required for process piping, electrical conduit risers, equipment anchor bolt clusters, drain sumps, and stairwell openings.

Frequent design revisions make robust coordination and revision tracking essential in the deck drawing workflow.

OPENING CLASSIFICATION

Detail the Void According to Its Structural Impact

≤ 6″
SMALL

Typically cut through the deck field without structural reinforcing. Locate openings relative to flute geometry to avoid cutting through a flute valley at a bearing condition. Show sleeve or cast-in-place pipe sleeves on the deck plan with a note referencing the MEP or piping drawing for sleeve type and firestopping requirements.

6″–18″
MEDIUM

Require trimmer angles or channel framing around the perimeter to re-establish deck edge support and transfer slab loads around the void. Detail the trimmer framing in section, showing connection to primary framing and deck attachment at the trimmer flange.

> 18″
LARGE

Must be defined and sized by the structural engineer of record. The detailer's role is to accurately represent the opening on the deck plan, show all supplemental framing in plan and section, and coordinate with the reinforcing drawing for slab edge reinforcing at the opening perimeter.

TAG
TRACEABILITY CONTROL

Every Opening Needs a Coordination Identity

Every opening on an industrial platform deck plan should carry a unique tag referencing a coordination matrix that links to the responsible trade drawing.

DECK PLAN
Opening tag
TRADE DRAWING
Responsible discipline
STATUS
Pending → Frozen

Coordination failure to prevent: A penetration shown on the piping drawing but omitted from the deck plan can remain undiscovered until concrete is already placed.

BIM COORDINATION REQUIREMENTS

The Deck Model as a Coordination Control Layer

01

Model Authoring Standards

Form deck must be modelled to LOD 350 or higher in Revit or Tekla, capturing exact deck profile, gauge, bearing conditions, edge closures, and opening locations. Generic deck families are insufficient — profile-accurate families that reflect actual cross-section geometry are required for reliable clash detection.

02

Clash Detection Responsibilities

The deck model must participate in federated clash detection against the structural model for bearing and attachment conflicts, the MEP model for penetration conflicts, and the equipment model for clearance above deck and loading conflicts with shoring zones.

03

Penetration Freezing Milestones

BIM execution plans should define a penetration freeze date — after which no new penetrations are added to the deck drawings without a formal RFI or design change notice. Detailers must advocate for this milestone early in the project schedule.

04

Revision Traceability

Each revision to the deck model should be cloud-marked and captured in the drawing revision block with a clear description. On large industrial projects with 10–30+ deck drawing sheets, revision traceability is a significant quality control requirement.

05

IFC Export & Interoperability

Where the BIM execution plan requires IFC exports for owner review or multi-discipline model federation, the deck model must be exported with correct IFC entity classifications (IfcSlab for the concrete slab, IfcPlate for form deck panels) and attribute data populated per the project's BIM data requirements.

LIVE COORDINATION MATRIX

Keep Every Penetration Accounted For

Maintain a live coordination matrix crossreferencing every opening by tag number, responsible trade, deck drawing sheet reference, status (pending/confirmed/frozen), and slab reinforcing requirement.

TAG NUMBER
TRADE
SHEET
STATUS
REINFORCING

Distribute the matrix to all disciplines at each BIM coordination meeting.

PROFILE-ACCURATE DECK FAMILIES

Use manufacturer-specific or accurately dimensioned deck profile families in Revit/Tekla.

Correct flute geometry is essential for clash detection and quantity takeoff. An incorrect profile depth can produce systemic area and weight miscalculations across the platform.

DRAWING QC CHECKLIST

Review every form deck drawing sheet against a discipline-specific QC checklist covering:

Bearing verification at all supports
Opening tag completeness
Pour stop elevation accuracy
Attachment pattern notation
Shoring plan cross-reference
Coating specification callout
INDUSTRIAL DECK COORDINATION PRINCIPLE

Every opening should be identifiable, modelled, structurally supported, trade-coordinated, revision-traceable, and verified before construction release.

Industrial Platform Detailing

Production Detailing Workflow & Key Takeaways

Bringing all of the preceding technical requirements together into a disciplined, repeatable production detailing workflow is the defining competency of an experienced industrial platform deck detailer. The following summarises the end-to-end workflow and closes with the core principles that separate competent form deck detailing from genuinely excellent industrial platform documentation.

End-to-End Production Workflow

01
Drawing Review
Confirm scope and constraints.
02
BIM Setup
Establish model and deck layout.
03
Openings Coordination
Coordinate penetrations and interfaces.
04
Drawing Production
Produce drawings and perform QC.
05
IFC & Revisions
Issue for construction and manage revisions.

Stage 1 — Structural Review

Confirm deck type, gauge, span direction, attachment pattern, shoring requirements, and coating specification directly from the structural engineer's deck specification sheet and general notes. Never assume conditions from previous projects because owner standards and EOR preferences vary significantly.

Stage 2 — BIM Model Setup

Establish control lines, load the correct deck profile families, reference supporting framing directly from the structural model, and lay out sheets with accurate end-lap and side-lap locations. Verify minimum bearing at each support before advancing further.

Stage 3 — Opening Coordination

Import all discipline penetration lists, assign opening tags, model supplemental trimmer framing where required, and perform initial clash detection. Issue a penetration coordination report to the project BIM coordinator.

Stage 4 — Drawing Production

Generate plan views, sections, schedules, and details directly from the coordinated model. Apply the quality-control checklist and complete an internal peer review prior to formal EOR submission.

Stage 5 — IFC & Revision Management

Issue IFC exports according to BIM execution plan requirements. Maintain revision tracking logs and process RFI responses and design change notices within 48 hours to avoid drawing-set lag on fast-track industrial projects.

Key Takeaways for Industrial Form Deck Practice

Bearing Is Non-Negotiable

Minimum 1½″ end bearing at every support must be verified analytically within the BIM model rather than assumed from general arrangement drawings.

Openings Drive the Schedule

Penetration coordination is often the longest-lead detailing activity. Begin coordination immediately and establish a penetration freeze date as early as practical.

Document the Shoring Plan

If shoring is required, the shoring plan is a formal deliverable. Issue, review, revise, and track it with the same discipline applied to deck drawings.

Specifications Override Conventions

Owner standards and project specifications frequently supersede SDI defaults. Review project requirements completely before beginning detailing work.

Final Industry Principle

Form deck detailing on industrial platforms is a discipline where the quality of coordination documentation — penetration matrices, shoring plans, revision logs, BIM clash reports, and status tracking systems — is as important as the deck drawings themselves. Invest in process infrastructure as aggressively as production output. The strongest projects succeed because coordination is treated as an engineered deliverable rather than an administrative task.
