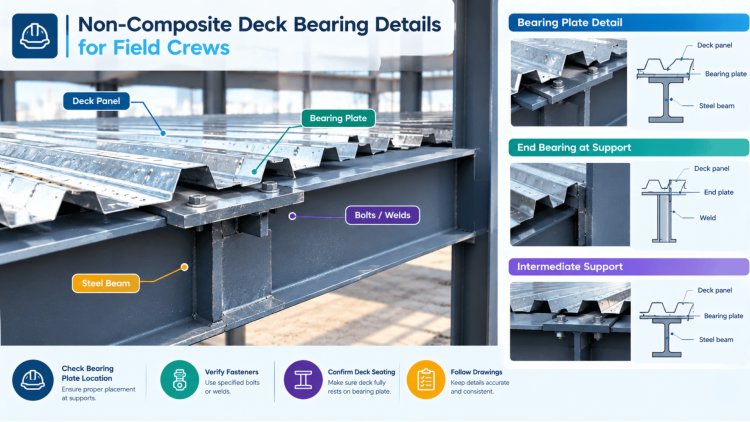

Non-Composite Deck Bearing Details for Field Crews

When a steel deck is non-composite, it carries loads purely through its own profile — no concrete-to-steel interlock, no shear studs, no shared structural action. That distinction changes everything about how bearing must be detailed, verified, and installed in the field. Get it wrong, and you risk edge uplift, deck walking, and dangerous instability during concrete pour. This guide cuts straight to what ironworkers, deck installers, and foremen need to know on-site: minimum bearing lengths, seat conditions, fastener patterns, and the inspection checkpoints that keep a non-composite pour safe from start to finish.

Non-Composite Deck Bearing Details for Field Crews
Non-Composite Deck Detailing

Why Bearing Details Matter on Non-Composite Decks

In composite deck systems, shear studs create a mechanical bond that helps stabilise the deck sheet at its ends. Non-composite decks carry no such benefit — the deck must transfer all load to the supporting beam or wall purely through its bearing seat and fasteners. This makes every millimetre of bearing length and every fastener location a structural decision, not just a site preference.

The Core Risk

Edge Instability

During wet concrete placement, non-composite deck is subjected to its highest loading condition. Without adequate bearing and fastening, sheets can rotate at their ends, "walk" laterally, or partially lift off the beam flange — all while the pour is live. These are not minor deviations; they are failure events that can injure workers and compromise the slab.

Understanding the interaction between joist and deck bearing is critical before erection begins.

What Field Crews Control
01

Bearing Length

Minimum 38 mm (1½ in.) on steel supports; 75 mm (3 in.) on concrete or masonry — measured from the support face to the deck end, not estimated by eye.

02

Seat Flatness

Any beam flange or bearing wall that is out of plane by more than the erection tolerance must be reported and shimmed before deck is placed.

03

Fastener Placement

Arc welds or powder-actuated fasteners at the correct centres — dictated by the structural drawings, never approximated in the field without engineering sign-off.

What Field Crews Control

Bearing Length • Seat Flatness • Fastener Placement

Field Installation: Step-by-Step Bearing Procedure

The sequence below applies to standard non-composite steel deck placed on structural steel supports. Always cross-check against the project's erection drawings and the structural engineer's specifications — these steps establish best practice, not a substitute for project-specific requirements. For related steel joist detailing protocols, refer to the Consac joist detailing guide.

1

Verify Support Alignment Before Placing Deck

Confirm beam top flanges are level and within erection tolerances. Check that bearing surfaces are free of mill scale buildup, excessive camber, or weld spatter that could raise a sheet off the flange. Any beam that is high by more than 6 mm relative to adjacent framing must be reported to the site engineer before deck erection proceeds.

2

Establish and Mark Minimum Bearing Lines

Snap a chalk line or mark each support beam to indicate the minimum bearing edge for the deck end. For steel supports, this is 38 mm (1½ in.) from the beam centreline to the nearest deck sheet edge — never less. On concrete or masonry bearing walls, increase this to 75 mm (3 in.) minimum.

These marks are your field QC baseline; a deck sheet that falls short of the line does not get welded.

3

Place and Align Deck Sheets

Lay sheets in the direction specified on the erection plan. For non-composite deck, the sheet end must bear fully and continuously across the support — no gaps, no tilting, no bridging over an out-of-plane flange. Side-lap ribs must be nested correctly before any fastening begins. Misaligned side laps are a common source of bearing gaps that compromise load transfer.

4

Fasten at Bearing Points First

Arc welds or powder-actuated fasteners at the deck ends (bearing supports) are the priority. These "button punches" or welds lock the sheet against lateral sliding and uplift. Weld washer requirements apply where the deck gauge is 22 ga. or lighter. Side-lap stitching follows bearing fasteners — never the reverse. Standard centres for end fasteners are typically 300 mm (12 in.) o.c. unless the structural drawing specifies closer spacing for wind uplift or pour pressure.

Side-lap stitching follows bearing fasteners — never the reverse.

5

Inspector Walk Before Concrete

Before the concrete truck arrives, the foreman or site engineer walks every bay: checking bearing length at edges, confirming fastener count matches the drawing schedule, verifying edge form attachment, and looking for any deck sheet that has shifted since installation. A simple tally sheet — one row per beam line — is the most reliable QC tool in the field.

Flag and fix before the pour; there is no correction after.

Non-Composite Deck Installation

Common Field Errors &
How to Catch Them

Most non-composite bearing failures in the field are not caused by wrong materials or inadequate design—they are caused by installation shortcuts that look minor until the pour is underway.

The table below identifies the errors field crews encounter most often, their consequences, and the corrective action to take before concrete is placed. For deeper context on deck behaviour in structural systems, visit the Consac blog.

Error 01

Insufficient bearing length at sheet end

ROOT CAUSE
Sheet placed short; bearing line not marked on flange.
CONSEQUENCE
End rotation and potential sheet drop during pour.
Field fix
Shift sheet before fastening; never weld short.
Error 02

Missing end fasteners at beam line

ROOT CAUSE
Crew stitched side laps first and skipped ends.
CONSEQUENCE
Sheet uplift and lateral walk under pour pressure.
Field fix
Always fasten bearing supports first; verify by count.
Error 03

Deck spanning over out-of-plane beam

ROOT CAUSE
Beam elevation error not caught in pre-erection survey.
CONSEQUENCE
Concentrated bearing stress, local buckling at end ribs.
Field fix
Stop, survey beam, shim or notify engineer.
Error 04

Side-lap gaps at interior supports

ROOT CAUSE
Ribs not nested; sheet forced rather than aligned.
CONSEQUENCE
Concrete leak, uneven slab soffit, ponding risk.
Field fix
Re-nest before stitching; inspect gap visually from below.
Error 05

Fastener centre too wide for uplift zone

ROOT CAUSE
Generic spacing used instead of drawing specification.
CONSEQUENCE
Deck lifts at perimeter bays in high-wind conditions.
Field fix
Read the structural drawing schedule for each bay zone.
Pre-pour requirement

Never begin a concrete pour until the foreman has signed off on a bearing and fastener inspection tally for every beam line in the bay.

Verbal confirmation is not sufficient—use a written checklist tied to the pour sequence.

Inspection tally
Bearing length verified at every sheet end
End fasteners counted at every beam line
Side-lap gaps inspected from below
Uplift-zone fastener spacing checked per bay

Non-Composite Deck Installation

Pre-Pour Checklist & Key Takeaways

Use this checklist as your final gate before concrete placement. Every item must be confirmed — not assumed. Print it, carry it on-site, and record the name of the person who verified each line. Non-composite deck has no shear stud safety net; the bearing detail is your only structural interface with the support below.

Final Pre-Pour Verification Checklist
Bearing length ≥ 38 mm on all steel supports confirmed and measured, not estimated
Bearing length ≥ 75 mm on all concrete/masonry walls confirmed
All end fasteners (arc welds or PAFs) installed at required centres per structural drawing
Side-lap stitching complete; no open gaps visible from below
Edge forms secured; perimeter deck anchored against uplift
No sheet ends bearing short of the marked bearing line
Beam flanges free of debris and weld spatter under bearing areas
Deck surface free of construction debris that could load the sheet unevenly
Site engineer or foreman walk-through completed and signed off
Pour sequence confirmed — begin at midspan, work toward supports
Key Takeaways for Field Crews

Bearing Is Non-Negotiable

In non-composite systems, the deck-to-support interface is the only load path. Short bearing is a structural deficiency, not a site tolerance issue.

Sequence Matters

Always fasten end bearings before side laps. Reversing this sequence is the single most common installation error on non-composite decks.

Read the Drawing, Every Bay

Fastener centres, weld patterns, and bearing minimums can change from bay to bay within the same floor. Generic field practice does not substitute for drawing compliance.

Stop Before You Pour

A checklist walk takes 20 minutes. A bearing failure during a live pour can injure workers, waste an entire slab, and delay the project by weeks. The return on that 20 minutes is absolute.

For more technical resources on deck and joist coordination, visit the Consac joist and deck blog series and the full steel joist detailing guide.

Key Takeaways for Field Crews

Bearing Is Non-Negotiable • Sequence Matters • Read the Drawing, Every Bay • Stop Before You Pour
